How Long do House Extensions Really Take?

Reading time: 6 minutes Author: Zak Gilby Published: 15 October 2025

If you’re planning a house extension, the question on your mind is likely: how long do house extensions take? It’s a fair one – after all, an extension is a big commitment of time, money, and patience. The truth is, there’s no one-size-fits-all answer. Some projects wrap up within six months, while others can stretch well over a year. The duration depends on your design, planning requirements, and the professionals involved.

At DeVis Architecture, we’ve guided homeowners across London and Surrey through every step of the process – from the first sketch to final sign-off. Below, we’ve outlined what really determines how long a house extension takes, what can cause delays, and when the best time to start is.

In This Article

1. How Long Do House Extensions Take on Average?
2. The Stages of a House Extension Project
3. What Can Cause Unexpected Delays to Extension Timelines
4. When Is the Best Time to Start a House Extension?
6. How to Plan Your Extension Efficiently
7. Can You Stay at Home During Construction?
8. Final Thoughts: A Realistic Timeline

How Long Do House Extensions Take on Average?

Across the UK, most extensions take 9 to 15 months from first consultation to completion. A straightforward single-storey rear extension under Permitted Development might be completed in around 6–9 months, whereas a double-storey extension, architecturally complex build or full home refurbishment could take 12–18 months.

The Stages of a House Extension Project

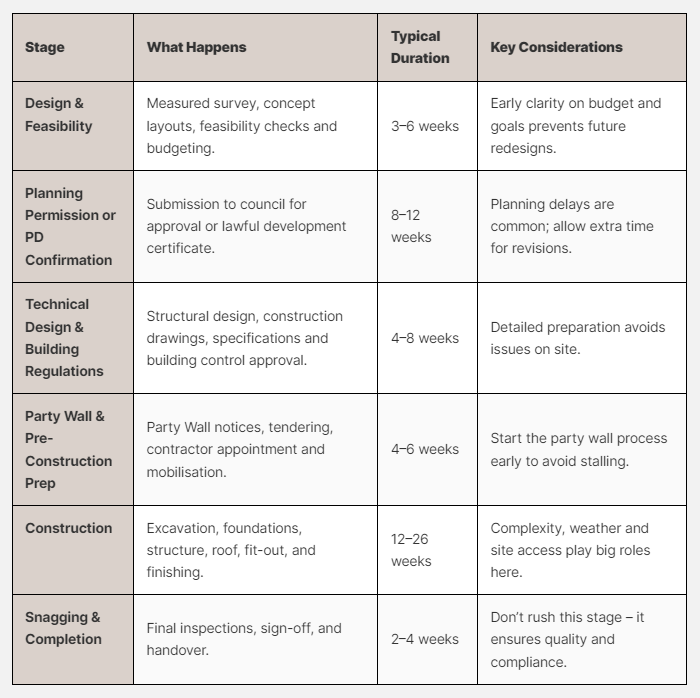

house extension stages and timelines

Total: around 9–15 months, though complex designs or planning hurdles can push beyond this.

By understanding the full process upfront, you’ll know what to expect – and when – which is key to avoiding unnecessary frustration and costly downtime later.

What Can Cause Unexpected Delays

Even with the best planning, some factors are simply out of your control. Here’s what can add weeks or months to your project:

Planning Delays
Council workloads vary significantly and planning decisions (both full planning permission and permitted development) can be delayed. Minor validation errors, officer holidays, or changes in assigned case workers can extend the standard eight-week window.

Party Wall Complications
Neighbours who ignore notices or object can trigger formal surveyor appointments. The party wall award process typically adds 4–8 weeks to the schedule.

Scope Changes
Last-minute design or material changes create knock-on effects – altering drawings, recalculating structures, and reordering materials.

Material Delivery Timelines
Bespoke glazing, steel beams, and joinery can have long lead times. Ordering early prevents construction pauses.

Weather Conditions
Rain, frost and heavy wind can stop groundworks and roofing entirely. Winter projects are especially vulnerable unless planned strategically.

Contractor Availability
Good builders are booked months in advance. Securing one early in the design phase can avoid seasonal bottlenecks.

Modern 3 Metre House Extension - Ribbon House
Modern 3 Meter House Extension – Ribbon House

When Is the Best Time to Start a House Extension?

The best time depends on what stage you’re in. To start building in spring or summer, your design and planning work should begin in autumn or early winter. That allows enough time for surveys, planning drawings, building regulations drawings and council approvals before construction-friendly weather arrives.

If your project requires planning permission, remember that approvals can take up to three months – or more if conditions or revisions are imposed. Builders also need notice to schedule your project, so it’s best to plan backwards from your ideal build date.

At DeVis Architecture, we often encourage clients to begin the design process between September and January, allowing for planning over winter and breaking ground by April or May. This sequence avoids weather delays and takes advantage of the drier, lighter months for structural work.

3 meter House Extension with Timber Cladding - Scarlet House
Timber Clad House Extension & Loft Dormer in South London – Scarlet House

How to Plan Your Extension Efficiently

A smooth extension project starts with organisation and clear communication. Here are our top insights from hundreds of residential projects:

Start by confirming your house extension budget and priorities early. Understanding what’s achievable helps avoid redesigns and resubmissions later. Next, assemble your team earlyarchitectural designers, structural engineers, and builders should ideally collaborate before planning submission. This prevents conflicting drawings and gives you more accurate quotes from the outset.

Keep your decision-making swift and consistent. Every week you delay approving drawings, house extension materials, or layouts can snowball into significant hold-ups further down the line.

Finally, choose experienced professionals familiar with your local authority and construction type. A team that regularly deals with planning in areas like London and Surrey will know the areas’ nuances and approval patterns – often shaving weeks off your schedule.

Large Single Storey Extension - Stage House
Modern Single Storey Extension – Stage House

Can You Stay at Home During Construction?

Many homeowners ask whether they can remain living in the property during the build. The answer depends on the extent of the work and your tolerance for disruption.

For single-storey rear extensions where most of the work is external, you can often stay put – though you may temporarily lose access to your kitchen or garden. Dust, noise, and fluctuating utilities are unavoidable but manageable with good site management.

However, for double-storey extensions, loft conversions combined with extensions, or major internal reconfigurations, moving out usually saves both time and stress. Builders can work faster and more efficiently without needing to keep areas habitable, often reducing the construction period and project cost by 10–20%.

If staying home is your only option, coordinate with your builder to phase the work strategically – for example, completing structural and dusty stages before tackling interiors.

Single Storey Extension & L-Shaped Dormer - Petite House
House Extension & Flat Conversion Plans – Petite House

Final Thoughts: A Realistic Timeline

So, how long do house extensions take? On average, 9–15 months from initial concept to completion is realistic for most homes across London and Surrey. Smaller permitted developments may take closer to six months, while larger, more complex projects can extend beyond a year.

The key to keeping on schedule isn’t rushing – it’s planning properly. A clear brief, early approvals, and coordinated professionals will save far more time than cutting corners ever could.

At DeVis Architecture, we manage every step of your extension journey – from surveys and planning drawings to technical design, specifications, and tender support. Whether you’re extending in Wimbledon, Fulham, or New Malden, we’ll help you achieve a well-designed, timely, and stress-free build.

FAQs

How long do house extensions take on average?
The honest answer is: it depends. Most house extensions across the UK take between nine and fifteen months from first consultation to final sign-off. That covers every stage - design, planning, technical drawings, approvals, and construction. A straightforward single-storey rear extension built under Permitted Development Rights can sometimes be completed in as little as six to nine months, while larger or more complex designs (such as double-storey additions or projects involving full refurbishments) often stretch to twelve to eighteen months. It’s important to remember that the actual “build time” - the period on site - might only be four to six months. The longer portion usually comes from design development, planning applications, building control checks, and party wall matters. Homeowners who start the process early and plan efficiently tend to save the most time. At DeVis Architecture, we break every extension into clear, manageable stages - from the initial survey to the day your new space is ready to enjoy. By understanding the entire process upfront, you’ll know exactly what to expect, when each milestone should happen, and how long your dream home transformation is likely to take.
What stages make up a typical house extension project?
Every extension follows a similar sequence, even if timelines vary. The design and feasibility stage (3–6 weeks) covers your survey, layout ideas, and budget. Next comes planning permission or permitted development approval (8–12 weeks). Once granted, we move into the technical design and building regulations stage (4–8 weeks), preparing detailed drawings and specifications. Then comes pre-construction, when your builder is appointed and materials are ordered (4–6 weeks). Finally, construction takes around 12–26 weeks, depending on size, weather, and site conditions, followed by snagging and sign-off (2–4 weeks). Altogether, that’s roughly nine to fifteen months from start to finish. Knowing each step helps manage expectations and avoid costly downtime - something we guide every DeVis client through from the outset.
What can cause delays to a house extension?
Even well-organised projects can face unexpected delays. The most common are planning hold-ups, as local councils often take longer than the target eight weeks to approve drawings. Party Wall disputes can also add four to eight weeks if neighbours delay responses. Material lead times are another factor - bespoke glazing, steelwork, and joinery can take up to ten weeks to arrive. Add to that weather interruptions in winter, and even small design changes mid-build can easily snowball into further delays. At DeVis Architecture, we help clients anticipate these challenges by ordering early, coordinating consultants closely, and aligning planning with realistic timeframes. That way, projects run as efficiently as possible, without compromising quality.
When is the best time to start a house extension?
If you want to start building in spring or summer, begin the design and planning stages in autumn or early winter. This gives enough time for surveys, drawings, and approvals before ideal construction weather arrives. For most clients, September to January is the perfect window to kick off the process. It means planning decisions are in place by March or April, and work can start once the ground is dry and days are longer. Even for Permitted Development projects, starting early helps you secure a reliable builder and plan materials in advance. At DeVis Architecture, we structure projects around seasonal efficiency - helping homeowners across London and Surrey avoid delays, reduce costs, and complete their extensions on schedule.
